How to Overcome Contractual Challenges for Data Center Projects – Part 1
- Jan 4, 2018
- 2 min read

This is the first in a series of six posts on how to overcome contractual challenges for data center projects. The series will address:
Part 1: Integration of Facilities & Technology
Part 2: Facility Design/Construction
Part 3: Technology Design/Implementation
Part 4: Network Services
Part 5: Migration Services
Part 6: Multi-Level Contract Relationships
This post will address the integration of facilities and technology. A turn-key data center project includes several discrete services and scopes of work that are normally not combined into a single contract for enterprise, colocation or cloud service provider data center projects. There is no single vendor that self performs the full stack of services for a complete turn-key solution. Data Center owners must understand the scope of service boundaries of their vendors to ensure that no overlap or gaps in scope exist.
Project Management 101 has shown how the value of clearly defining all the services and scopes of work required is critical for a successful project. However, this can be challenging for a turn-key data center project where procurement methods, industry standard contract language and quality control processes vary significantly between:
facility design & construction
technology design, procurement & implementation
selection and implementation of network services
migration planning & implementation

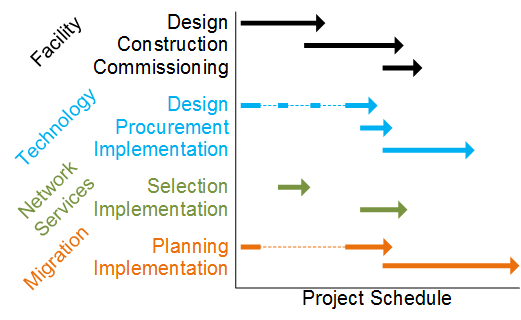

If these primary areas of responsibility are not integrated or coordinated it will have an adverse impact on the success of the project, including cost, schedule or quality. Some of the possible adverse effects include:
Disconnect between Owner’s expectations and budget
Level of redundancy or reliability of critical support systems, or expected availability of IT services, less than required by Owner
Unnecessary constraints on IT operations due to facility or technology design decisions made
Data Center capacity (space, power, cooling, network, compute, storage) not aligned with IT system forecasts
Data Center operating costs in excess of projections
Disorganized schedule with disruptive overlaps or gaps between primary areas of responsibility
Incomplete budgets with gaps, or disorganized budgets with overlaps, between primary areas of responsibility
The three basic approaches that can facilitate a seamless integration and coordination between these primary areas are:
Owner manages each of these primary areas separately with internal personnel
Owner selects one vendor to act as prime for the turn-key project, with the prime vendor being responsible for all other vendors that provide products and services outside of the prime vendors core skills and services
Owner selects a Data Center Program Manager consultant to plan and execute coordination and integration between all primary areas of responsibility, Data Center Program Manager is independent of vendors responsible for design, construction, procurement, implementation and IT services
Each of these basic approaches can work well, resulting in a successful project, as long as it is clear who has the responsibility and skills to ensure there are no disruptive overlaps or gaps in scope, budget and schedule. Whoever is responsible for the integration and coordination between the primary areas of responsibility must have significant experience on data center projects and be knowledgeable in the full stack of data center vendor services including: data center facility design & construction; technology design, procurement & implementation; network services selection & implementation, and; migration planning & implementation.


I really enjoyed this colorful and creative post. The nostalgic idea behind pink bubble gum makes the design feel fresh and engaging. It shows how simple colors can inspire strong emotions and memorable styles, while even a practical topic like mediacom router login can benefit from clear presentation.
The weak point in these arrangements is often not the contract form itself, but the handover between disciplines. A practical safeguard is to maintain one shared responsibility matrix covering design approvals, power and cooling interfaces, technology installation, testing, and migration readiness. Each item should have a clear owner, deadline, and acceptance standard so that gaps become visible before they affect commissioning. This is also where strong site-level coordination matters, which makes the CIOB Level 3 Diploma in Site Supervisory relevant for supervisors responsible for monitoring workmanship, communicating changes, and escalating interface risks before they become contractual disputes.
many references to quantity surveyor course pathways emphasize technical estimating skills, while procurement route selection receives comparatively less attention. several industry publications suggest that procurement strategy can reshape risk allocation before construction begins. how these strategic decisions are embedded into training frameworks is not always clearly outlined.
At the highest level of construction leadership, nvq level 7 construction management represents advanced competence in strategic project and organisational control. The qualification focuses on managing complex operations, teams, and budgets at senior level. It is designed for experienced professionals responsible for major construction decisions.
Mình có lần lướt đọc mấy trao đổi trên mạng شيخ روحاني thì thấy nhắc nên cũng tò mò mở ra xem thử cho biết. Mình không tìm hiểu sâu rauhane chỉ xem qua trong thời gian ngắn để quan sát bố cục s3udy cách sắp xếp các mục và trình bày nội dung tổng thể. Cảm giác là các phần được trình bày khá gọn, các mục rõ ràng nên đọc lướt cũng không bị rối Berlinintim, với mình như vậy là đủ để nắm tin cơ bản rồi. q8yat
